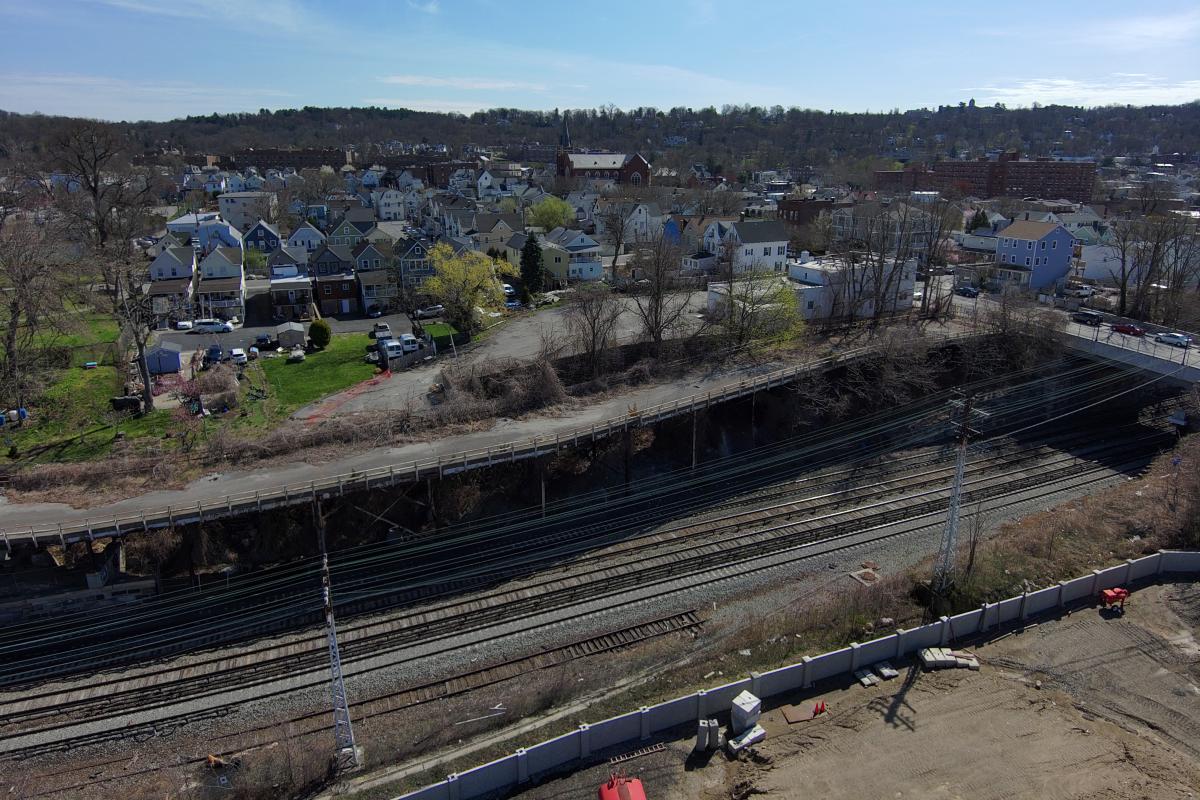

Viaduct Demolition by Sessler Wrecking
Demolition Prep
- Temporary structural supports installed
- Vegetation removed from above and below structure
- Protective tarps installed at the MNR overhang
- Portion of deck saw-cut to prep for removal
Week 1
- Concrete deck panels removed from the structure and staged for removal of rebar
- Saw-cutting completed, approximately 30% of concrete removed
Week 2
- 100% of the concrete deck removed from the structure
- Concrete panels crushed to separate rebar from concrete
Week 3
- Concrete debris collected from under the viaduct
- Steel superstructure precut to prep for steel removal
- Concrete rubble and boulder stockpiles run through the crusher for reuse on-site under future project phases
Week 4
- 250 Ton mobile crane mobilized to site
- Approximately 40% complete steel removal
Week 5
- Viaduct Demolition Complete
- Site Cleanup and Contractor Demobilization
